The bathroom tiles come off on day two. Behind them, the wall crumbles like wet cake.
That’s when many owners learn their renovation was never about tiles. It was about what the tiles were hiding.
If you’re renovating an older property in Sharjah, you can keep the location and layout you love. You just need to find the surprises before your contractor does.
Inspect First, Paint Later
Fresh paint won’t fix dampness behind a wall. Before choosing finishes, work out what still works.
Walk every room and note cracks, damaged ceilings, uneven floors, peeling plaster and doors that no longer close. You can’t judge a crack’s cause by looking at it, so don’t guess.

| What you see | What it may mean | Who to call |
|---|---|---|
| Hairline plaster cracks | Often cosmetic | Monitor them |
| Wide cracks, sagging slab | Possible movement | Structural engineer |
| Damp patches, peeling paint | Leak or failed waterproofing | Waterproofing specialist |
| Warm sockets, flickering lights | Ageing wiring | Licensed electrician |
| Weak AC cooling | Poor insulation or an old unit | AC technician |
Check bathrooms, balconies and roofs closely. Replacing pipes or wiring before new finishes go in costs far less than opening a new ceiling later. Sharjah Municipality’s maintenance permit service also includes an inspection of the building’s condition.
Sort Out Permits Before the First Hammer Swing
Repainting a room and removing a wall are legally different things. A contractor willing to start doesn’t mean the work is authorised.
| Type of work | What to check | Who to ask |
|---|---|---|
| Paint, tiles, fixtures | Apartment building rules | Building management |
| Repairs and maintenance | Maintenance permit, inspection | Sharjah Municipality |
| Removing walls, extensions | Technical review, amended drawings | Municipality, consultant |
| Fire protection changes | Safety review | Sharjah Civil Defence |
To get a Sharjah Municipality maintenance permit:
- Gather your property documents, existing construction permit and architectural plans.
- Add the contractor’s agreement and licence, plus the consultant’s if you have one.
- Submit, then wait for the municipality’s inspection.
A published guide says processing takes up to four working days after inspection. Requirements vary by property, so confirm them first.
For structural changes, Sharjah Civil Defence runs a separate service for approving amendments to residential house drawings. In apartments, ask building management about the NOC, working hours and rules for moving materials.
UAE-wide note: each emirate runs its own approvals, so Sharjah’s steps don’t automatically apply in Dubai or Abu Dhabi. Check the local authority first.
Check Heritage Value Before You Rip Anything Out

Not every old building needs a makeover. Original doors, façades and decorative details are hard to recreate once they’re gone.
Sharjah is working to identify and protect modern architectural heritage. A September 2026 Sharjah Art Foundation announcement described a committee set up for that purpose. That doesn’t mean your property is protected. It does mean you should ask about preservation or planning restrictions before removing distinctive features.
Photograph everything first. If a feature is in good shape, restoring it is often smarter than replacing it.
Build a Budget That Survives Surprises
Visible upgrades are easy to price. The hidden work behind them isn’t. A realistic renovation budget in Sharjah starts by splitting your list in two:
- Essential: structural repairs, wiring defects, leaks, waterproofing
- Optional: upgraded finishes, lighting, extra storage
| Cost area | Often forgotten | Tip |
|---|---|---|
| Inspection and consultancy | Engineer or design fees | Ask early |
| Permits and approvals | Application fees | Confirm with the authority |
| Demolition and debris | Removal and site prep | Get it itemised |
| Plumbing, electrical, AC | Hidden repairs | Add a contingency |
| Temporary housing | Storage, rent | Include it |

Misconception: similar floor areas mean similar costs. A lightly refurbished apartment and a villa needing major repairs can have very different budgets. Keep the contingency separate from your upgrade money.
Choose a Contractor Who Understands Older Buildings
A contractor who only builds new can struggle with ageing services, past alterations and hidden defects. A good renovation contractor in Sharjah can explain how they handle surprises.
How to vet one:
- Check the Sharjah licence and confirm the work falls within its authorised activities.
- Ask for comparable projects and references.
- Verify any consultants and specialist trades the same way.
- Get itemised quotations listing materials, quantities, labour and exclusions.
Need names to start with? AddressGuru UAE is a business directory where you can browse contractors, consultants and AC specialists by location and service. Use it to build a shortlist, then verify each company’s licence and past work yourself.
Be wary of very low quotes that skip work or describe materials vaguely. The cheapest offer can become the most expensive once missing items appear.
Put it in the contract:
- Scope, materials and payment milestones tied to completed stages
- Completion date, exclusions and how changes are approved
- Who obtains approvals, removes waste and fixes defects
- Warranties on workmanship, materials and equipment
If it isn’t written down, it isn’t agreed.
Match Materials and Safety to the Building
Heat, humidity, dust and strong sun wear down finishes, window seals and waterproofing.
- Windows and cooling: check seals, insulation and AC capacity. Poor seals make rooms uncomfortable in hot weather.
- Moisture: bathrooms, kitchens, roofs and balconies need extra care. Ask which waterproofing system will be used and how it will be tested.
- Structure: never cut into beams, columns or slabs, or remove a possible load-bearing wall, without professional assessment and approvals.
- Electrics and fire safety: have qualified professionals check wiring and the distribution board. If work touches alarms, escape routes or approved fire-safety drawings, ask whether extra approval is needed.
The UAE Government’s building safety guidance explains the role of local authorities.

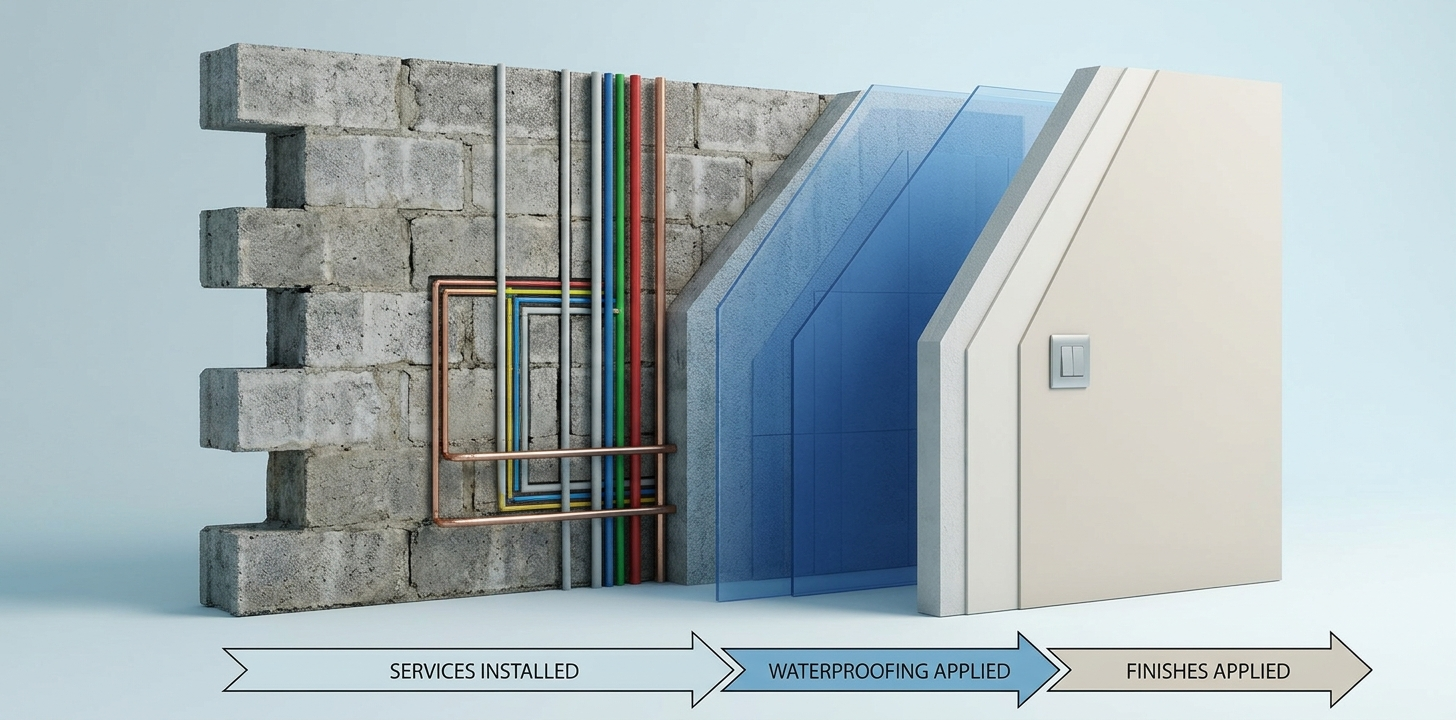

Follow the Right Order of Work
Wrong sequencing means rework, and rework means money.
| Stage | What happens | Why the order matters |
|---|---|---|
| 1. Inspect, scope, permits | Surveys, drawings, approvals | Avoids stop-work surprises |
| 2. Demolition, structural repairs | Remove and fix | Hidden damage shows here |
| 3. Plumbing, electrical, AC | Services go in | Must precede finishes |
| 4. Waterproofing | Seal wet areas | Protects what’s above |
| 5. Finishes | Walls, flooring, cabinets, paint | Last, to avoid damage |
| 6. Testing and inspection | Check every system | Catches defects early |

Build in flexibility, since approvals, materials and unexpected damage cause delays. If you’re staying in the property, discuss dust control and water or power interruptions.
Inspect Everything Before Handover
A quick walkthrough isn’t enough. Test every tap, drain, outlet, light, AC unit, door and window. Look closely at tiles, paintwork, sealant joints and any areas that previously leaked.
Then prepare a snag list with correction dates, and keep invoices, warranties, manuals and revised drawings. Ask whether you need a final inspection too. Sharjah Municipality’s maintenance completion certificate service includes inspecting completed work. Learn the handover requirements before the work ends, not after the final payment.
Start With What You Can’t See
Renovating an older property in Sharjah can improve comfort, safety and long-term usability. But the best results begin with decisions nobody photographs.
Fix the underlying problems first, then spend on appearance. A renovation built around the building’s real condition is far more likely to look better, work properly and stay easy to maintain.
